FERC Order 1920 reforms electric transmission planning

Tuesday, May 14, 2024

US electricity regulators have issued a major order addressing the nation's policy on regional planning of the electric transmission grid. The Federal Energy Regulatory Commission describes its Order No. 1920 as "the first time in more than a decade that FERC has addressed regional transmission policy – and the first time the Commission has ever squarely addressed the need for long-term transmission planning."

FERC adopted Order No. 1920 at its May 13, 2024 Open Meeting, by a vote of 2-1. Captioned "Building for the Future Through Electric Regional Transmission Planning and Cost Allocation", Order No. 1920 spans 1,364 pages

Issued in Docket No. RM21-17-000, the order adopts a final rule revising the Commission's pro forma Open Access Transmission Tariff (OATT) "to remedy deficiencies in the Commission's existing regional and local transmission planning and cost allocation requirements." As described by FERC, the order "finds that sufficiently long-term, forward-looking, and comprehensive regional transmission planning and cost allocation to meet long-term transmission needs is not occurring on a consistent and sufficient basis". According to FERC, this results in "piecemeal transmission expansion that addresses relatively near-term transmission needs" and "transmission providers investing in relatively inefficient or less cost-effective transmission infrastructure", causing customers to incur costs and miss benefits. This, according to the Commission, "in turn renders Commission-jurisdictional regional transmission planning and cost allocation processes unjust and unreasonable."

To remedy this problem, the order prescribes specific requirements that regional grid operators and transmission providers must follow in conducting long-term planning for regional transmission facilities and in allocating their costs. Among other reforms, it requires transmission operators to engage in long-term planning, with a 20-year time horizon, and a process for updates at least once every five years. It requires planners to consider seven specific categories of benefit, to determine whether a regional proposal will efficiently and cost-effectively address long-term transmission needs. These benefits are:

  1. avoided or deferred reliability transmission facilities and aging infrastructure replacement;
  2. either reduced loss of load probability or reduced planning reserve margin;
  3. production cost savings;
  4. reduced transmission energy losses;
  5. reduced congestion due to transmission outages;
  6. mitigation of extreme weather events and unexpected system conditions; and
  7. capacity cost benefits from reduced peak energy losses.

The order includes provisions designed to "right-size" transmission facilities, by which FERC means considering cost-effective expansion to increase transfer capability, whenever replacement is needed. Incumbent transmission owners will have a right of first refusal to develop these "right-sized" transmission facilities.

Order 1920 also gives states key responsibilities in planning, selecting, and determining the cost allocation for transmission lines, while continuing to require that customers pay only for projects from which they benefit. It also creates a process giving states and interconnection customers the opportunity to fund some or all of the cost of a long-term regional transmission facilities that otherwise would not meet the transmission provider’s selection criteria.

Commissioner Christie dissented, asserting that the order exceeds FERC's legal authority and fails to protect consumers. The order is set to take effect 60 days after its publication in the Federal Register. Order No. 1920 requires one set of compliance filings within 10 months of its effective date, with another round concerning interregional coordination due within 12 months of the effective date.

New England electric load to grow, grid operator says

Monday, May 6, 2024

Electricity consumption in New England will increase by about 17 percent over the next ten years, according to the regional grid operator, mostly due to the electrification of heating and transportation.

ISO New England tracks and projects power generation as well as consumer demand. Its 2024-2033 Forecast Report of Capacity, Energy, Loads, and Transmission (CELT Report) provides a ten-year look at projected power system characteristics.

According to the grid operator, 2024 represents an inflection point in New England's electricity use, as the regional trend shifts from declining power consumption, back to significant growth.

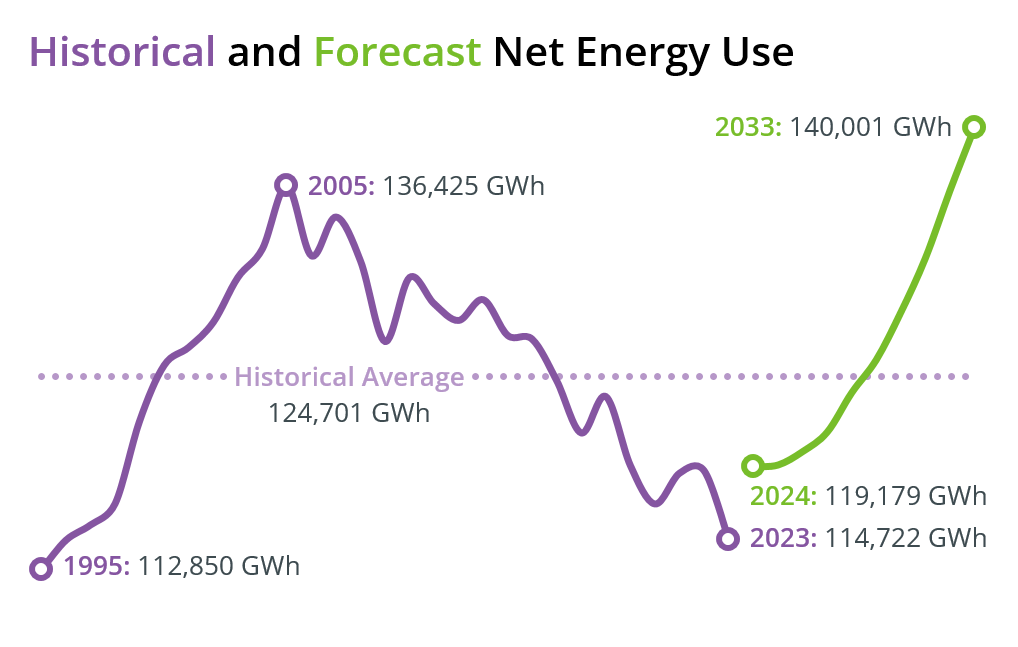

From 1995 to 2005, net annual energy use in New England grew steadily. ISO-NE attributes the growth primarily to "increased economic growth and the use of air conditioning". Since peaking in 2005 at 136,425 gigawatt-hours, net annual energy use in the region has generally decreased. ISO-NE attributes the reduction primarily to "an increase in energy efficiency from advanced cooling and heating technologies, energy-efficient appliances and lighting, and the increased prevalence of BTM solar generation."

Now, ISO-NE projects another reversal of this trend, as it forecasts "steady growth in net annual energy use as state policy goals for carbon emissions reductions drive the increased electrification of heating systems and transportation in the region." The grid operator projects that electric vehicles (EVs) "will account for 15,182 GWh of energy use in 2033, while heating electrification is expected to account for 7,996 GWh that year." After considering growth in behind-the-meter solar and efficiency measures, these projections represent an increase of about 17% in regional net annual energy use; meeting these needs will likely require significant new generating plants and transmission facilities.

ISO-NE also projects that the region will shift from summer-peaking to winter-peaking soon after 2033, due to heating electrification. Specifically, the grid operator expects winter demand to grow faster (3% annually under typical weather conditions) than summer demand (1%).

ISO-NE notes that behind-the-meter solar power "does not reduce winter peak demand, because the peak typically occurs after sunset."

US proposes Gulf of Maine offshore wind site auction

Wednesday, May 1, 2024

The U.S. Department of the Interior has proposed the first offshore wind energy auction in the Gulf of Maine. The process has potential to advance the development of large-scale offshore wind projects in New England.

BOEM's Proposed Sale Notice for ATLW-11 appeared in the Federal Register on May 1, 2024. According to the Bureau of Ocean Energy Management, the proposed "Atlantic Wind Lease Sale 11 (ATLW-11)" would cover about one million acres of the Outer Continental Shelf offshore Maine, Massachusetts, and New Hampshire. BOEM plans to divide this zone into eight lease areas, which it says could collectively support about 15 gigawatts of offshore wind generation.

BOEM selected these areas for leasing through a process that included a 2022 Request for Information (considering public comments and impacts to resources regarding a broader 13.7-million-acre area),  a 2023 Call for Information and Nominations, the 2024 identification of a Wind Energy Area (WEA) in the Gulf of Maine, and environmental reviews.

BOEM says that in identifying the ATLW-11 areas for leasing, it "prioritized avoidance of offshore fishing grounds and identification of vessel transit routes, while retaining sufficient acreage to support the region’s offshore wind energy goals (13-18 GW based on information from Massachusetts, Maine, and ISO-New England)." For example, in response to requests from members of the fishing community, BOEM created three corridors between leases in the southern region of the Final WEA to facilitate existing and future transit through proposed lease areas.

According to BOEM, it has notified the following entities that their qualification is pending or that they are qualified to participate in any Gulf of Maine auction:

  • Avangrid Renewables, LLC
  • Equinor Wind US LLC
  • US Mainstream Renewable Power Inc
  • Diamond Wind North America, LLC
  • Hexicon USA, LLC
  • TotalEnergies SBE US, LLC
  • Pine Tree Offshore Wind, LLC
  • OW Gulf of Maine LLC
  • Repsol Renewables North America, Inc
  • Maine Offshore Wind Development LLC
  • Corio USA Projectco LLC

Any other entity wishing to participate in any Gulf of Maine auction must submit the required qualification materials to BOEM by July 1, 2024.
